Investment & delivery case · Bay of Kotor, Montenegro

Demining Boka Kotorska

A bay-wide underwater UXO clearance programme — completing a century-old legacy risk that two flagship developments have already proven can be cleared safely, on budget, and turned into value.

3,170,000 m² identifiedDepths to 60 m€46,000,000 programme
MARSAFEUNDERWATER OPERATIONS CENTRE
The problem

A century of munitions in a living, working bay

Naval mines from the First World War; bombs, torpedoes and depth charges from the Second; ammunition delivered to Tivat and Kumbor and reportedly dumped uncontrolled during the 1991–92 Yugoslav breakup. Sea-dumping of obsolete conventional — and possibly chemical — munitions was standard practice until the 1975 London Convention banned it.

30+ tfound at the bay entrance alone (2018–19 RCUD survey, 500,000 m²)
Unknownauthorities do not know the location of many remaining stockpiles
1975London Convention ended legal sea-dumping — decades too late for this bay
MARSAFEUNDERWATER OPERATIONS CENTRE
Scale of what remains

3,170,000 m² of seabed, mapped and waiting

Seven zones across the bay, from the Risan approach to the outer entrance at Rose, at depths down to 60 metres — precisely bounded, not a guess.

3,170,000 m²
MARSAFEUNDERWATER OPERATIONS CENTRE
The estimate, zone by zone

Not an open-ended commitment — a bounded, mapped programme

ZoneAreaDiving depth range
Zone 1120,000 m²0–55 m
Zone 2200,000 m²0–45 m
Zone 3300,000 m²0–45 m
Zone 4250,000 m²30–45 m
Zone 5300,000 m²0–45 m
Zone 6500,000 m²0–60 m
Zone 71,500,000 m²0–60 m
Total3,170,000 m²up to 60 m

Zone geometry per the RCUD/GEATEH schematic survey map (2022). See the full map for exact locations across Risan, Kotor–Perast, Bijela, Kumbor, Đenovići and the outer bay entrance at Rose.

MARSAFEUNDERWATER OPERATIONS CENTRE
Proof of delivery

This is not a new capability — it is a proven one

Verige Strait

65 t
2004 — narrowest passage in the Bay.

Tivat Arsenal

17 t
2008 — ahead of Porto Montenegro.

Kumbor

~10 t
2014 — ahead of Portonovi.

MONITA cable

8.5 t
2018 — Italy–Montenegro interconnector.

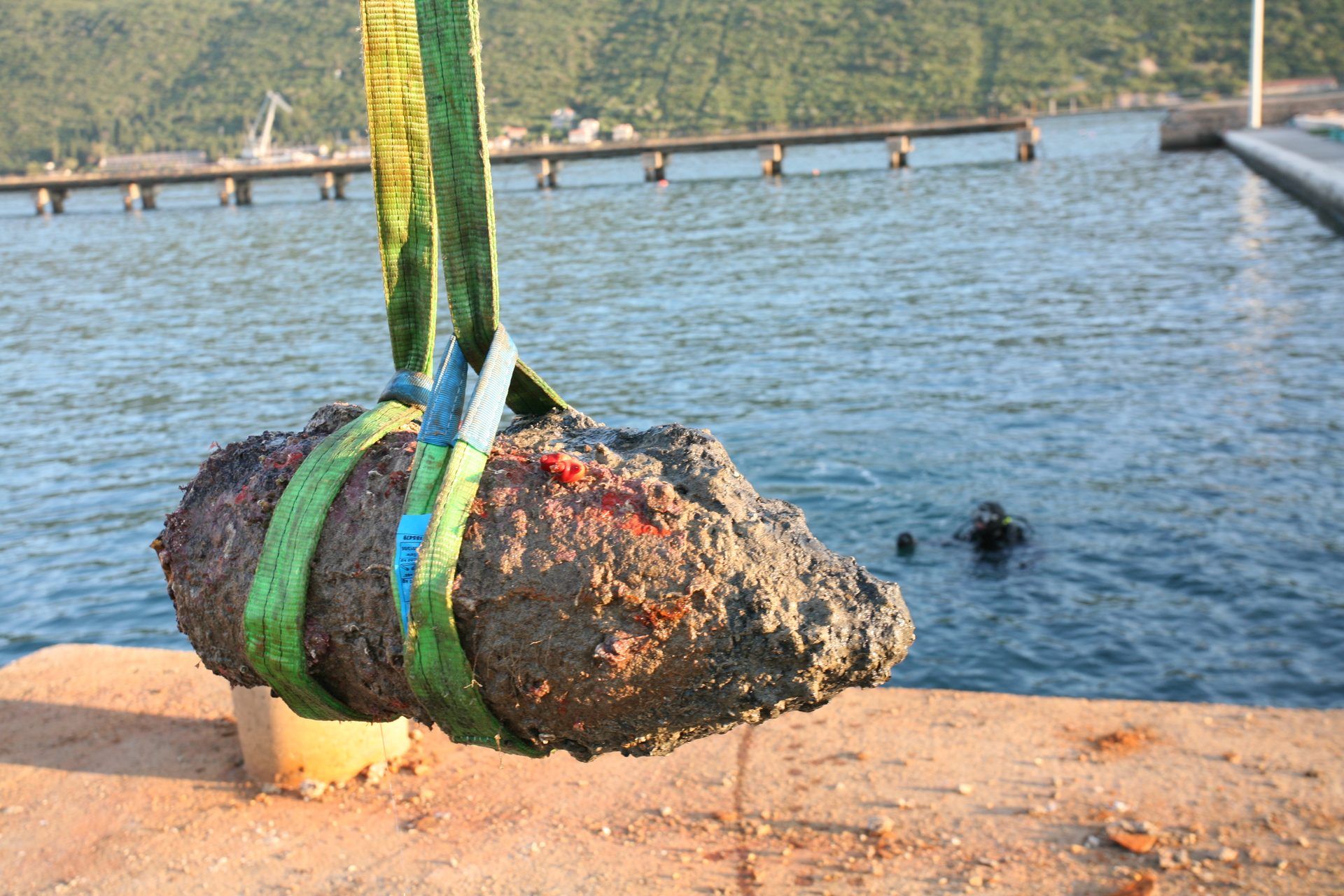

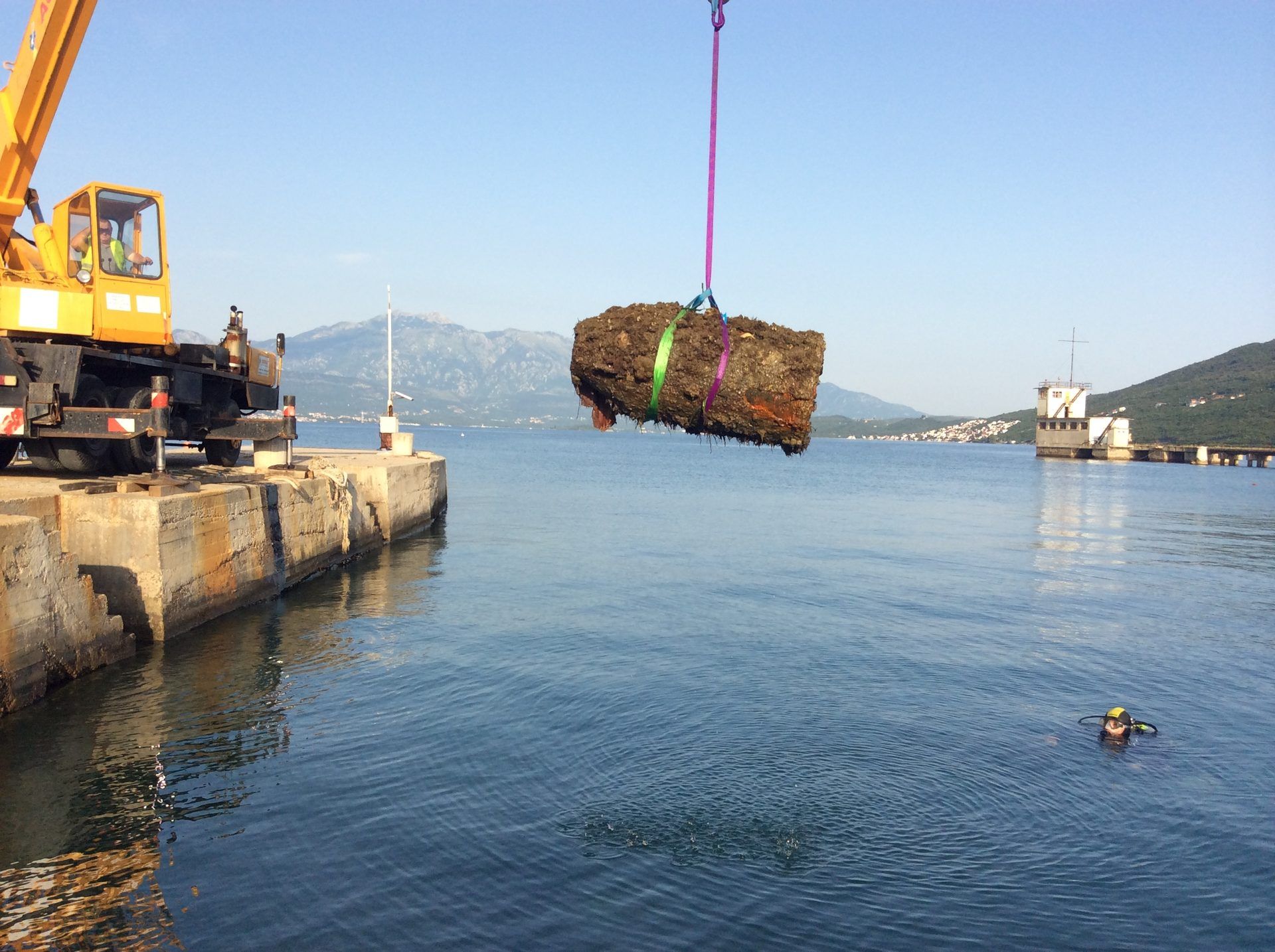

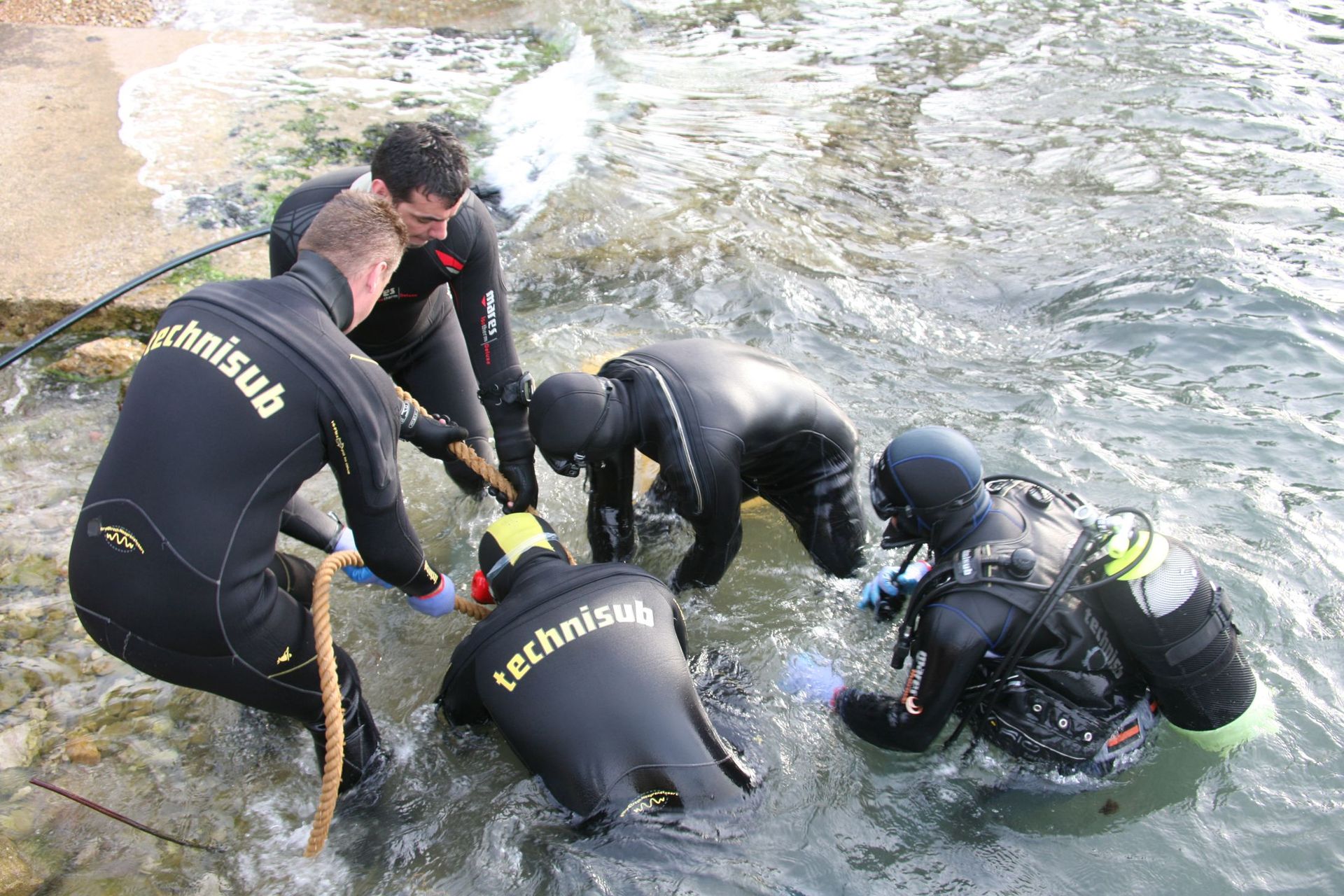

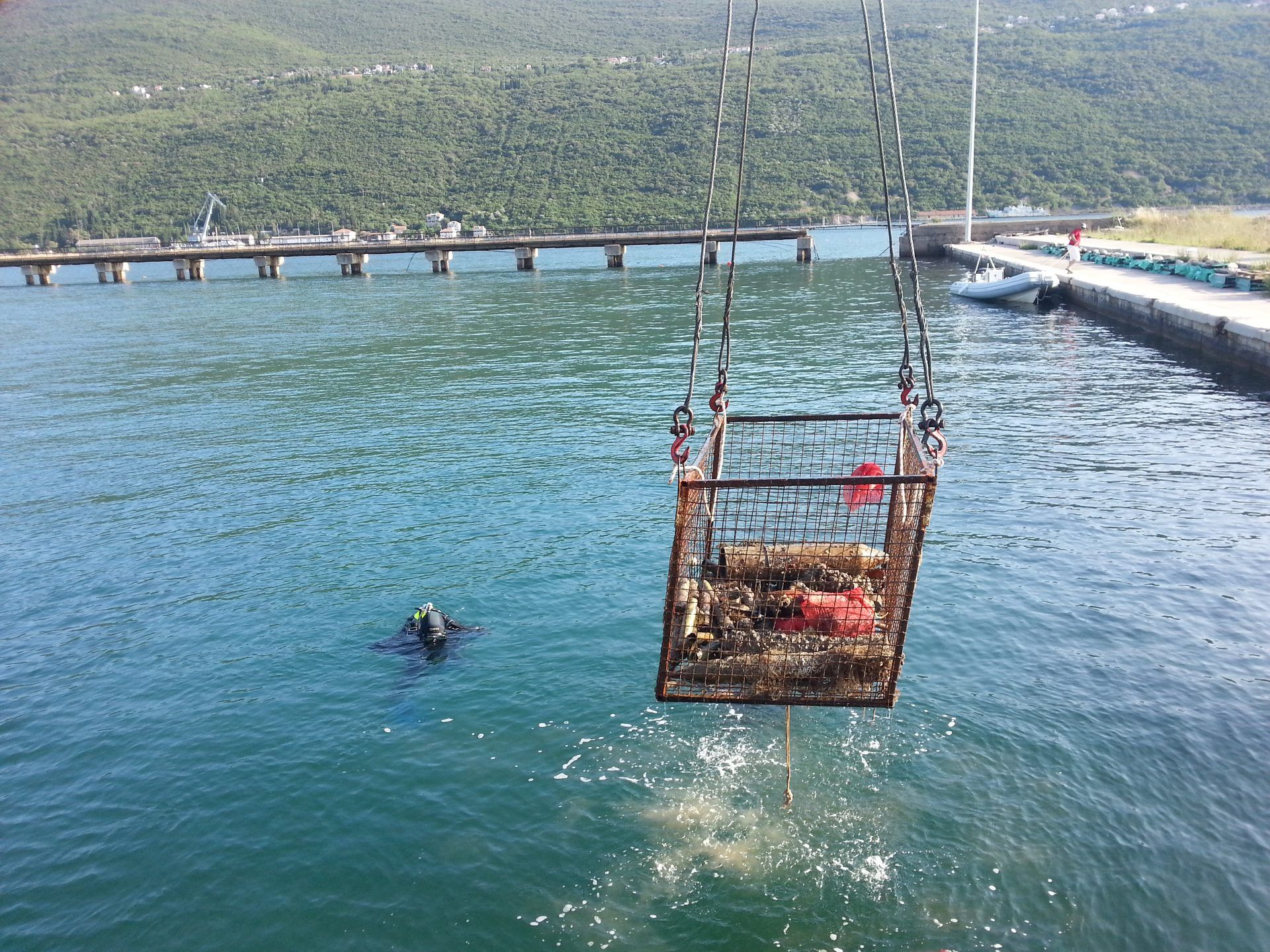

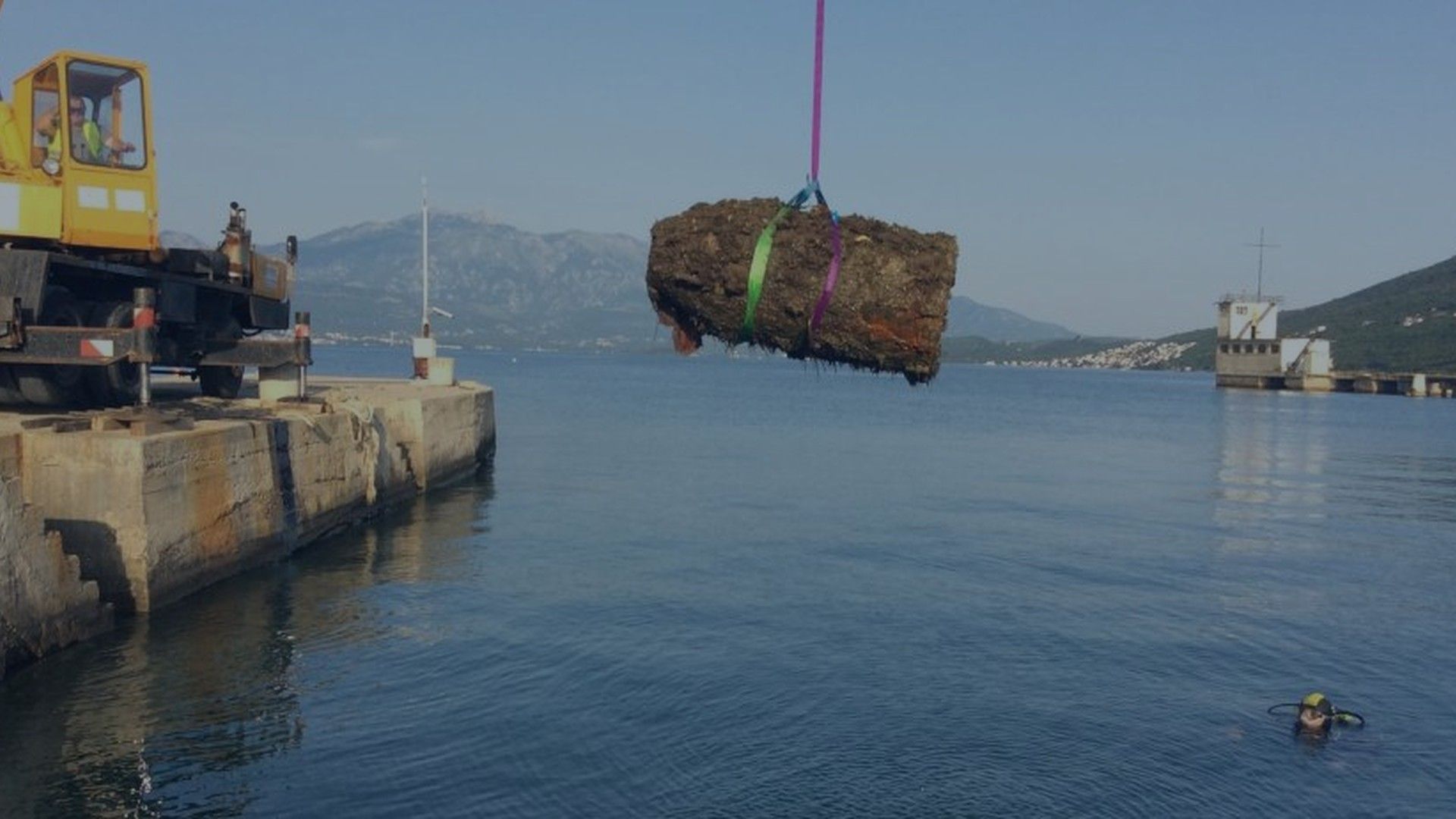

Approximately 100 tonnes of explosive ordnance removed across four documented operations — with zero reported incidents.

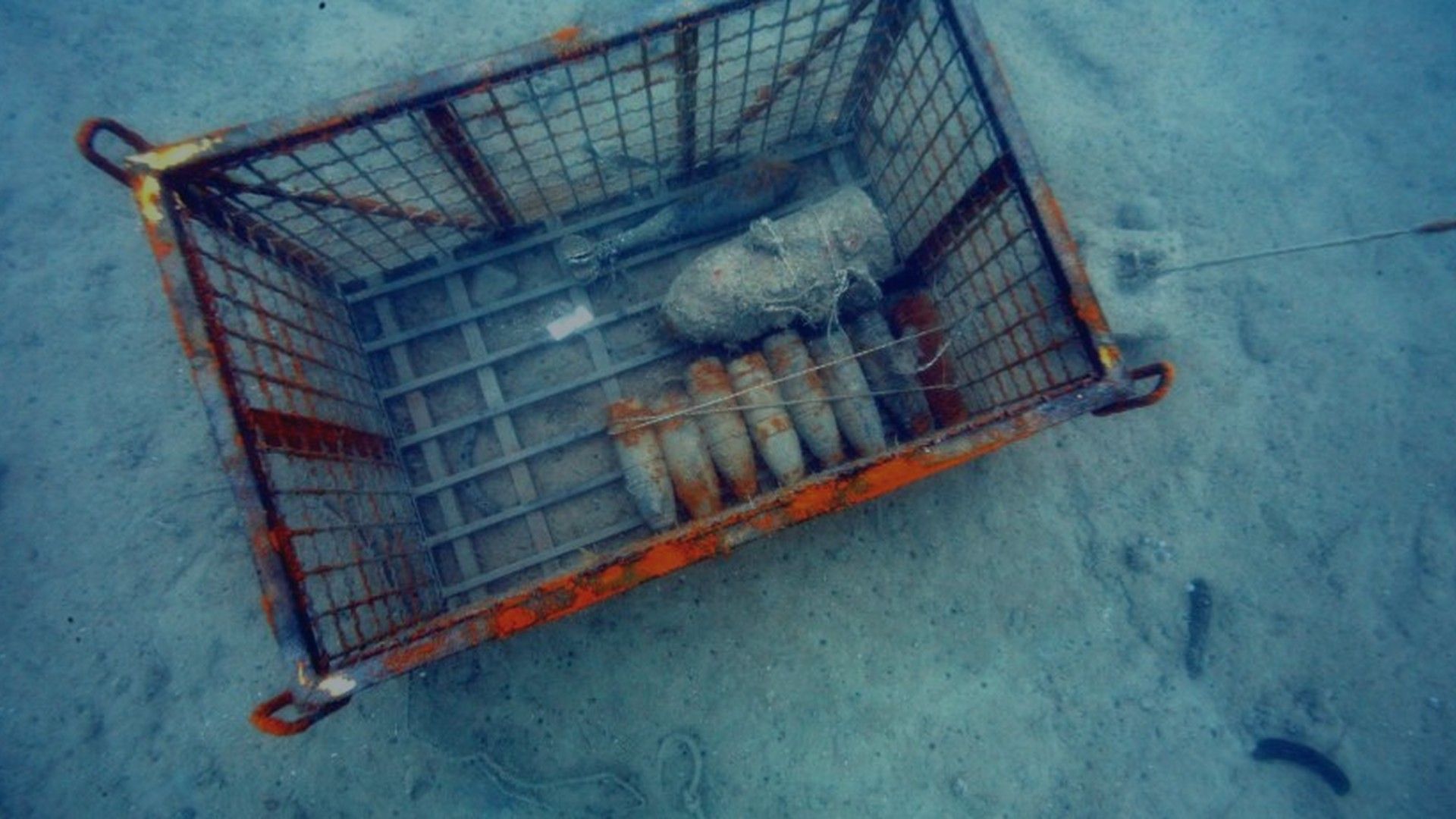

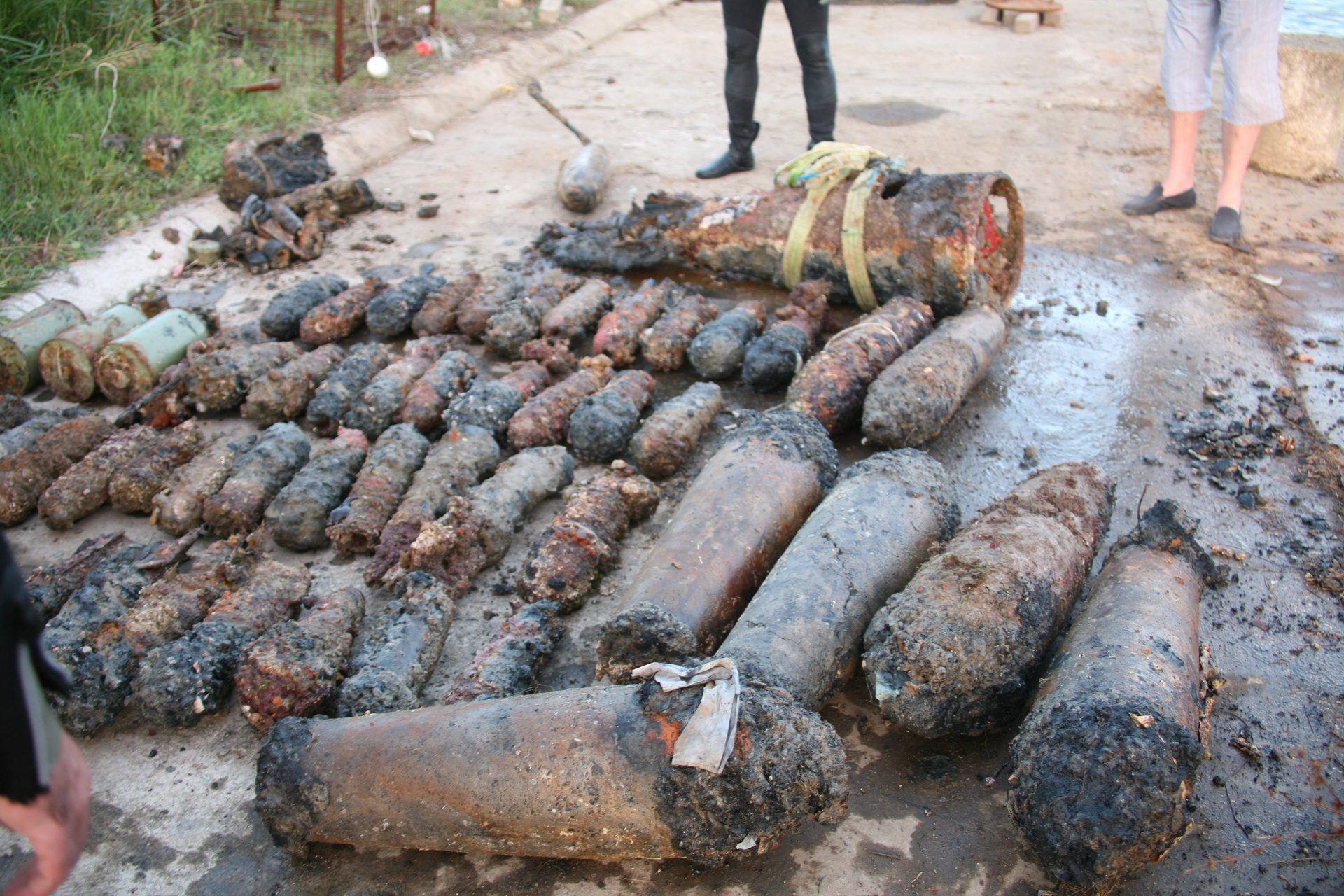

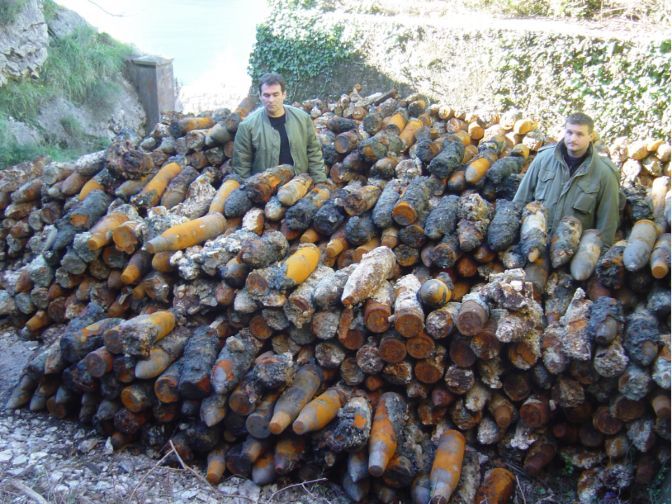

Recovered ordnance stockpile, Kumbor clearance operation, ahead of Portonovi.
MARSAFEUNDERWATER OPERATIONS CENTRE
Why this can't wait

Time will not resolve this — it only adds exposure

01

Still live

Recovered ordnance has repeatedly tested as fully functional, with factory markings intact after decades submerged at 30–40 m.

02

Growing exposure

Rising yachting, diving and nautical tourism traffic increases the odds of accidental contact every season the bay stays uncleared.

03

Uncontrolled recovery

Scrap collectors are drawn to recoverable metal and explosives; illegal dynamite fishing is periodically detected in the wider region.

04

Corrosion is a clock

Possible chemical munitions among the dumped ordnance corrode over time, releasing toxic degradation products into sediment and the food chain — a risk that only grows.

MARSAFEUNDERWATER OPERATIONS CENTRE
How it gets delivered

A disciplined, three-phase delivery model

Phase I

Pre-removal engineering

Records search, remedial investigation, bathymetric & electromagnetic survey, feasibility study, ammunition catalogue.

Phase II

Removal design

Explosive Safety Submission; method aligned to IMAS, RCUD and SEEMACC standards; seasonal work-window planning.

Phase III

Removal action

UXO-qualified excavation & identification; disposal in place by detonation, the preferred method; full HS&E risk management.

MARSAFEUNDERWATER OPERATIONS CENTRE
Targeting, not guessing

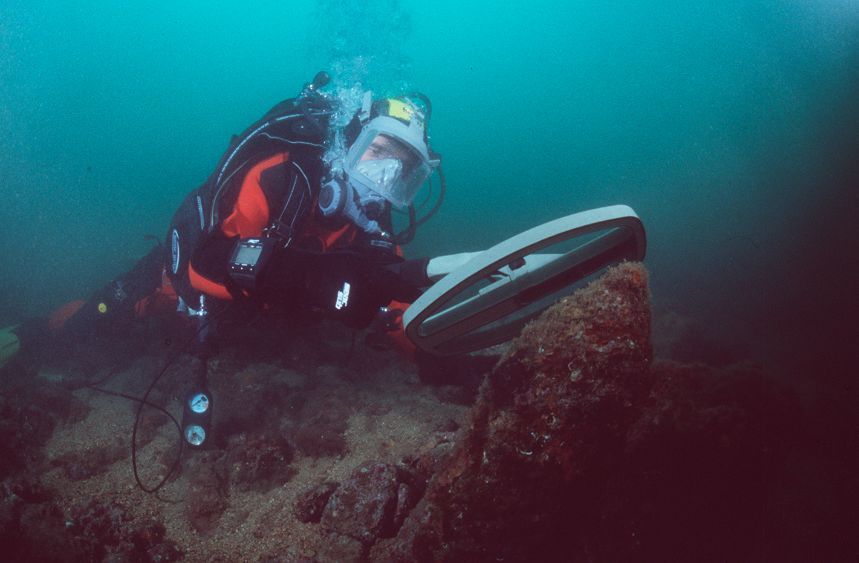

How hidden ordnance is actually found

01

Archive & records search

Historical maps and national archives overlaid on current geography via GIS, narrowing the search before a diver ever enters the water.

02

Geophysical survey

Dual-sensor magnetometry, electromagnetic detection and multibeam bathymetry across 100 m × 100 m sample plots.

03

Community intelligence

Coastal residents and fishermen — who know where debris and wrecks sit because that is where fish congregate — provide leads authorities alone do not have.

04

Diver verification

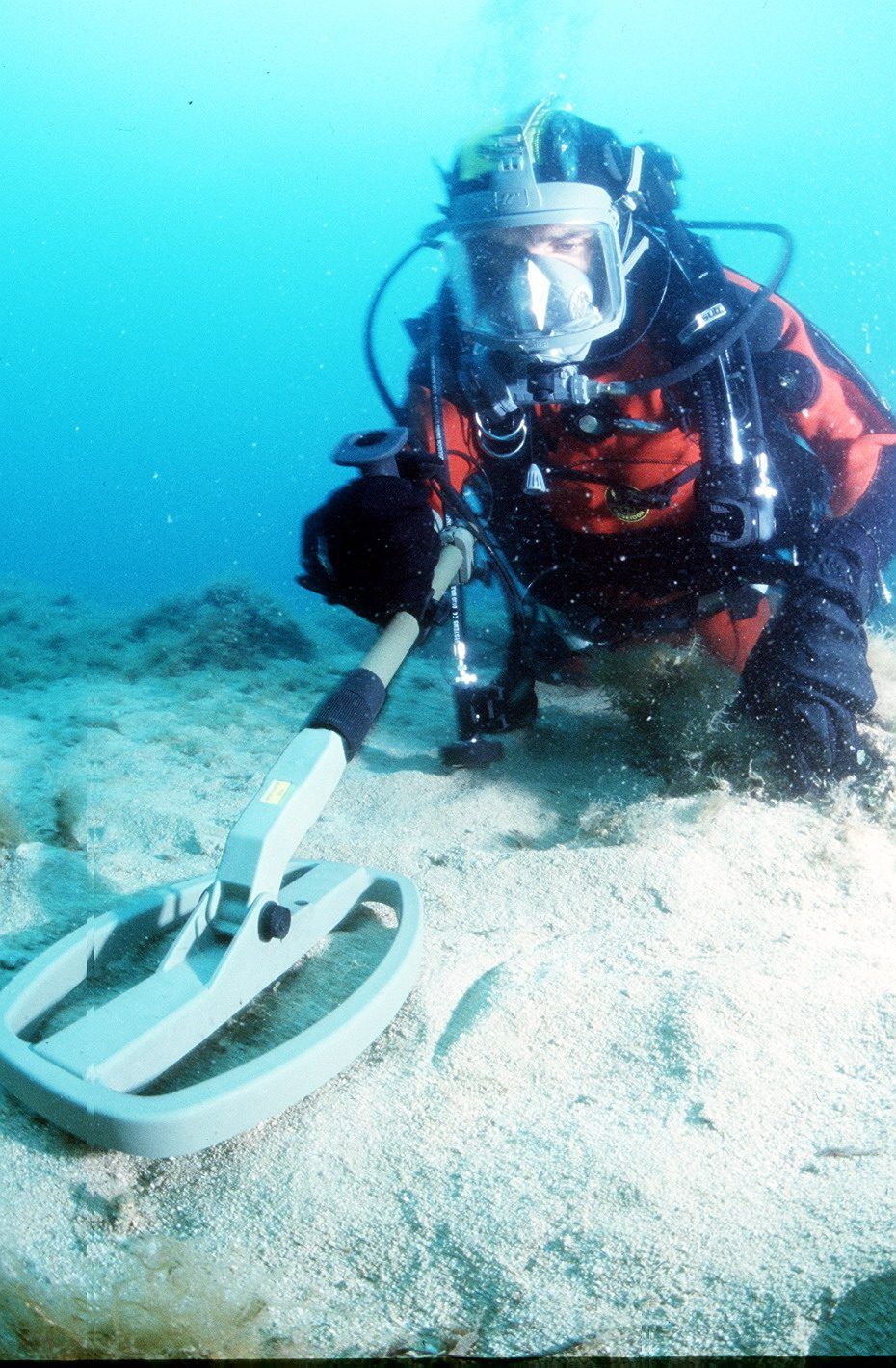

Every significant magnetic signature is confirmed in person — the only reliable way to distinguish ordnance from an engine, hull or vehicle.

MARSAFEUNDERWATER OPERATIONS CENTRE
Standards & safety

Built to international mine-action standards

Operations run to IMAS (International Mine Action Standards), RCUD's own Operational Procedures, and the South Eastern Europe Mine Action Coordination Council (SEEMACC) framework — with a full Health, Safety & Environmental plan governing every working day.

Apr–Julfirst seasonal working window (favourable weather)
Sep–Decsecond seasonal working window
0diving in Jul–Aug (peak yachting traffic) or Dec–Apr (weather)
MARSAFEUNDERWATER OPERATIONS CENTRE
Who can actually deliver this

A high, deliberate bar to entry — and RCUD already clears it

01

Track record required

Court-registered demining organisation, 10+ years' referential experience, 1,000,000+ m² demined, €2,000,000+ generated from underwater demining.

02

Certified people

5+ certified underwater deminers, 5+ divers rated NORMOXIC-TRIMIX to 39–60 m, a certified gas-blender, 2+ diving instructors, 2+ Special Naval Operations-certified staff.

03

Certified equipment

Hyperbaric chamber aboard the working vessel; 5+ certified underwater anti-mine detectors rated to full operating depth.

04

Qualified leadership

EOD-qualified Team Leader with military-engineering credentials, ~10 years' experience and international project-management track record.

MARSAFEUNDERWATER OPERATIONS CENTRE
Return on clearance, already demonstrated

Where a private beneficiary exists, this already pays for itself

Arsenal → Porto Montenegro and Kumbor → Portonovi were both privately financed, once RCUD's survey defined the clearance scope developers needed to build. The result: a reported €500M+ investment at Portonovi alone, two international waterfront destinations — and, in June 2026, Porto Montenegro hosting the EU–Western Balkans Summit on a site that was a minefield eighteen years earlier.

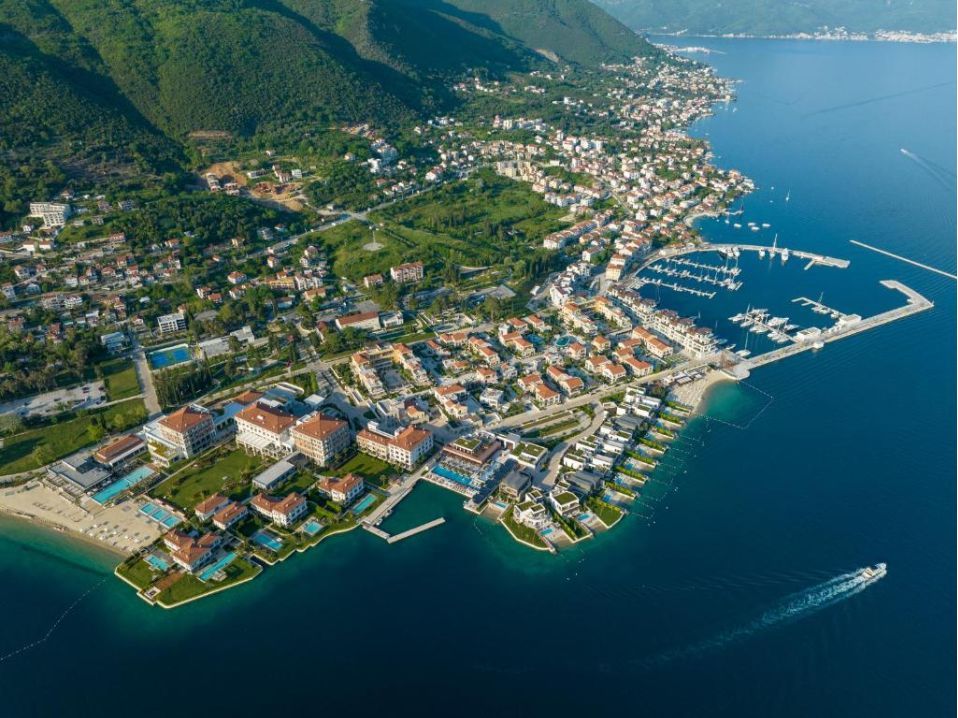

Portonovi today — from minefield to a reported €500M+ waterfront development.
MARSAFEUNDERWATER OPERATIONS CENTRE
Why the rest needs public capital

No developer is coming for the other 3 million square metres

Most of what remains sits under fishing grounds, navigation channels and open public waters — the Verige Strait model, not the marina model. There is no private site owner to bill for it, and if clearance is left to wait for one, the highest-risk, lowest-commercial-value waters go to the back of every queue, indefinitely.

"Where private beneficiaries exist, their capacity to pay should release public resources towards precisely the waters no investor will ever finance."

MARSAFEUNDERWATER OPERATIONS CENTRE
The ask

A fully costed, bounded programme

€46,000,000

Lidar mapping of the full bay bottom (87,330,000 m²) · identification of explosive objects across 3,170,000 m² · plan of action & permitting · removal and deactivation of UXO · independent supervision throughout.

Work items — 75%
Supervision — 25%
Work items (mapping, identification, removal, deactivation) — ~€34.5MIndependent contracting-authority supervision — ~€11.5M
MARSAFEUNDERWATER OPERATIONS CENTRE
How the programme runs

A phased pathway, delivered season by season

Stage 1

Full-bay Lidar mapping and records-based historical assessment.

Stage 2

Zone-by-zone geophysical survey and target identification (3,170,000 m²).

Stage 3

Removal design, permitting and Explosive Safety Submission per zone.

Stage 4

Removal action, delivered across successive Apr–Jul and Sep–Dec working seasons.

Stage 5

Verification, sign-off and re-survey of each cleared zone.

Scope is bounded and mapped, but delivery is necessarily seasonal — no diving occurs during peak yachting traffic (Jul–Aug) or the winter weather window (Dec–Apr).

MARSAFEUNDERWATER OPERATIONS CENTRE

Partner with us to finish the job

Two sites are already cleared, built, and hosting European heads of state. The rest of the bay is mapped, costed, and ready — it needs a funding partner, not another study.

Who we're looking forFunding & delivery partners

Government co-financing · EU accession & resilience funds · international donors · security & NATO-linked infrastructure programmes · private co-financing for zones adjacent to future development.
